Cat Tree Quality Control: What Buyers Should Inspect

A cat tree QC plan should start with the approved sample and documented specification, not with a generic pass/fail list. Before production approval, the buyer and project team need one current reference for dimensions, component identities, finish, hardware, assembly information and packing. Before shipment, representative production units should be checked against that same reference.

This matters for flat-pack cat trees because the final result depends on several interfaces: boards and platforms must align with posts; inserts and bolts must engage correctly; coverings must be finished around holes and edges; and the packed set must contain the parts, hardware and instructions needed to reproduce the approved assembly. QC should document what was inspected, what differed and who accepted any deviation. It should not turn one sample, one measurement or one test into a product-line guarantee.

Start QC with the Approved Sample and Specification

The inspection reference should be closed before production units are judged. At minimum, identify the approved sample or sample revision, the current drawing or product specification, component or BOM definitions, finish and covering references, hardware list, assembly-manual revision, packaging specification and approved change record. If two documents show different part codes or dimensions, that conflict should be resolved before an inspector decides which version is correct.

Verbal instructions are difficult to trace across sampling, production and final packing. A dated revision record turns changes—such as a platform position, post length, fabric color, hardware finish or carton layout—into inspectable requirements. It also prevents an earlier sample from becoming the accidental production reference after a later change has been approved.

The broader Cat Tree Sourcing Guide explains how materials, structure, packaging and supplier documentation fit into the full sourcing decision. This article stays with the narrower QC question: what to compare and what evidence to retain.

Specification boundary: The correct value is the value approved for that SKU or project. Board thickness, fabric weight, sisal diameter, post diameter, base dimensions and load requirements are not universal cat tree standards.

Separate the Inspection Question, Approved Criterion and Verified Result

A useful inspection record keeps three different states separate:

Record stateWhat it means
Suggested inspection questionA buyer or project team identifies something that should be checked, such as component identity, post alignment, hardware completeness or packing contents.
Project-approved acceptance criterionThe named SKU or project defines the required value, reference, method, condition, sample or revision, applicable limit and approval owner.
Verified inspection resultThe inspector records what was actually observed or measured on identified units, together with the date, evidence, deviation and disposition.

A suggested checkpoint does not become a production requirement until its criterion and approval basis are defined. A result from one unit, lot, model or revision should not be presented as a universal HOMVND standard or a result for the complete product range.

Check Materials and Components Before Assembly

For an incoming material or component check, first connect the received item to the named component, SKU or project revision and approved material or finish reference. Where project traceability requires a lot or batch identifier, record it with the inspection evidence. A visual match alone does not establish material identity, performance or compliance.

Component inspection is most useful while the flat-pack set is still separated. For boards, platforms and bases, confirm the part identity, specified dimensions and thickness where applicable, edge and surface condition, hole positions and finish reference. A panel can look acceptable by itself yet create an assembly problem if its hole pattern, insert position or orientation differs from the approved drawing.

Posts, sisal and textile-covered parts need their own definitions. Check post identity and dimensions, rope coverage and attachment, covering color and texture, seams, finished edges, and the treatment around openings and hardware interfaces. This is not a reason to impose one rope or textile specification on every model. The inspection question is whether the production component matches the approved reference for the named project.

For bolts, threaded inserts, brackets, washers and tools, compare identity, finish and count with the current hardware list and manual. Substitute fasteners can affect tool fit, connector engagement or the order of assembly even when they appear similar. If spare parts are required, the SKU or project record should state which part and quantity rather than relying on a general expectation.

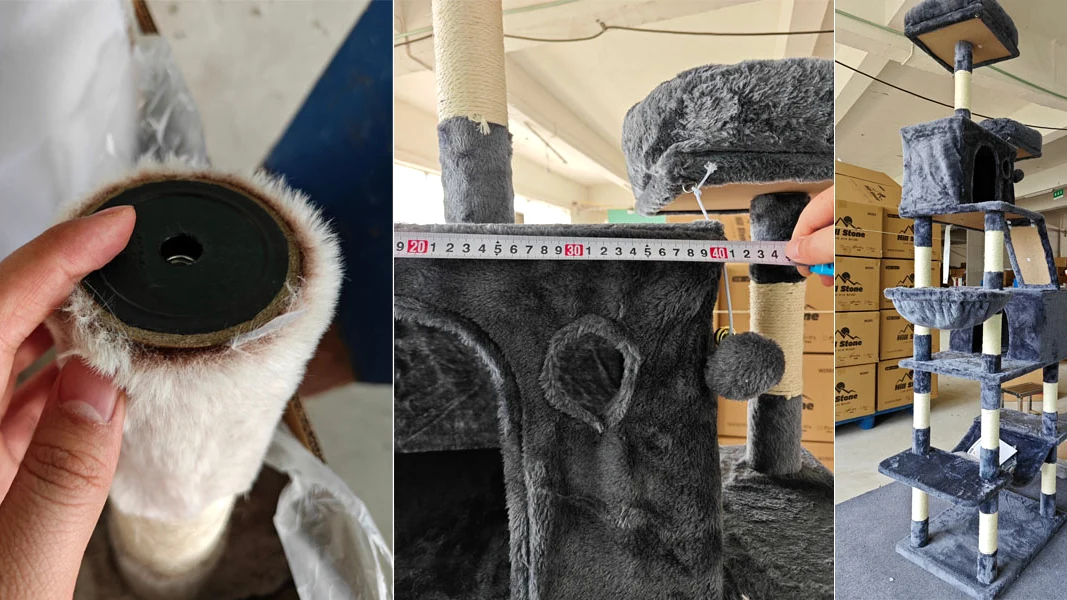

Cat tree boards, posts, coverings and hardware reviewed against product specifications
Boards, posts, coverings and hardware arranged for component review against the approved product reference.
Tape measure checking the diameter of a wrapped cat tree post

Review Structure and Assembly as One System

An assembled review should use the same method and checkpoints applied to the approved sample. Start with the base on the intended flat surface. Confirm that it sits flat, then review the relationship between height, base and platform layout; post-to-board connections; supported and cantilevered areas; hole alignment; and connector engagement. Wobble is an observation to investigate, not a stand-alone claim that a product is safe or unsafe.

The assembly sequence can expose problems that a finished showroom sample conceals. Note any forced alignment, incorrect part, missing component, blocked hole, loose insert, tool mismatch or step that does not agree with the manual. When a model includes a wall-fixing or anti-tip component, check its identity and instructions against that model’s approved specification. Do not generalize the presence or performance of that feature to other models.

One showroom sample cannot represent all packed production units. The final plan should define how representative units are selected and which checkpoints are repeated. An assembled-unit record is more useful when it identifies the unit, specification revision, assembler, date, findings and disposition. Photos should show the relevant connection or alignment point, not only a distant view of the finished product.

Assembled cat tree structure and connection points reviewed during quality inspection
An assembled cat tree reviewed at the base, posts, platforms and connection points without implying a universal safety or load result.

Diagnose Common Cat Tree Problems Without Guessing the Cause

A complaint or failed assembly is a starting observation, not a confirmed root cause. Before deciding that a post, hole, fastener, covering or packing step caused the problem, connect the finding to the named SKU, configuration, revision, unit and assembly condition. Keep five states separate: observed deviation, possible cause, inspection point, recorded finding and project disposition.

If support or fixing conditions matter to the finding, first identify whether the product is freestanding, wall-mounted, floor-standing with wall anchoring, floor-to-wall or true tension floor-to-ceiling. The Cat Tree Structure Types guide explains those boundaries without treating the labels as mutually exclusive.

Observed issueWhat to verify firstEvidence for the decision
Wobble or loose postSurface, base contact, part identity, seating, mating interface and assembly stateIdentified-unit views, manual revision and connection record
Leaning post or misaligned platformPost length and orientation, platform ID, hole/support map and contact surfacePart codes, measurements and trial assembly against the approved reference
Hole mismatch or blocked connectionPart identity, orientation, revision, hole position and hardware matchDrawing comparison, measurement and trial-fit record
Wrong or missing hardwareBag identity, count, labels, tool, BOM/manual revision and packed-set completenessHardware checklist, unpacking record and assembly result
Rope gap or looseningApproved coverage, exact location, end fixation, rope/core condition and use historyClose views, component or lot identity and applicable process or test record
Fabric lifting or exposed stapleActual fixing route, backing/interface, affected location and handling conditionClose views, approved sample and applicable fixation record
Board chip or edge damageComponent, edge or hole location, inspection stage, handling and pack contactPart/lot identity, stage record and relevant packing views
Loose insert or end fittingActual end-part identity, retention interface, core condition and assembly/use historyBOM or section reference, movement record and project-specific test where required

Start by making the problem reproducible. Record the buyer or customer description in its original terms, then add the SKU and revision, affected part codes, unit or carton identity, date, assembly step, support surface, hardware used and close views of the actual interface. A distant photo of a completed cat tree rarely shows whether the wrong post, an earlier manual or a mismatched fastener was involved.

Use possible causes as investigation routes, not conclusions. Wobble may require checking base contact, node seating, component identity and assembly history; it does not justify increasing tightening force without a product-specific instruction. A hole mismatch should trigger identity and revision checks before a drilling conclusion. Rope or fabric observations should be compared with the approved coverage, sample and actual fixation route rather than an assumed adhesive or universal material rule.

Then connect the evidence to a project decision. The responsible owner may require containment, sorting, replacement, rework, repacking, a document correction or another agreed action, but the choice and acceptance criteria remain project-specific. Record the affected scope, action owner, reinspection method, result and closure approval. If a component, hardware pack or manual changes, route the revision through the Cat Tree Product Development guide before treating the corrected unit as the new reference. When supplier response and evidence control are under review, use the Cat Tree Supplier Evaluation framework rather than turning one complaint into a general capability conclusion.

This diagnostic framework does not publish a universal severity class, acceptance limit or root-cause claim. It gives buyers a traceable way to move from a reported problem to evidence, a project decision and a closed record.

Inspect Hardware, Parts Identification and Assembly Information

Flat-pack QC needs to treat the hardware pack, component labels and manual as one information system. A correct bolt is still a packing failure if it is omitted, placed in the wrong bag or identified with a code that does not match the manual. Check the hardware-bag identity, count, label, specified tool and packing position. Look for missing items, unexplained duplicates and mixed fasteners that are difficult to distinguish during assembly.

Component identification should follow the same codes across the part list, labels and assembly steps. Post length or connector position may be more important than visual similarity when several covered posts look alike. The final manual revision should show the same parts and sequence as the packed production set, including any approved change introduced after sampling.

HOMVND’s approved knowledge records that, for applicable SKUs, hardware-pack weighing, extra fasteners or spare parts, and component labels may be used to reduce missing-part, wrong-part and assembly-error risk. That is a scoped practice, not a promise for every order. The applicable SKU, weighing method, spare quantity and label method still need project evidence.

Cat tree hardware, instructions and QC documents checked during product review
Hardware, component samples, instructions and QC documents prepared for a traceable product review.

Check Appearance and Finish After Assembly

Appearance inspection should be performed after assembly as well as at component level. Assembly can reveal panel misalignment, compressed coverings, seams that rotate into visible positions, exposed edges, marks around bolt locations and inconsistent finishing at openings or platform boundaries. Review all customer-visible surfaces under consistent lighting and compare color and texture with the approved reference.

Record scratches, stains, adhesive residue, loose threads, uneven rope transitions, distorted fabric, visible hardware and gaps between connected parts. The objective is production consistency against the approved sample, not a consumer-style opinion about whether the design looks attractive. If a visual tolerance is important, define it in the project documents rather than asking the inspector to invent one during final QC.

Where several finishes or private-label variants share a structure, separate their references. Approval of one fabric color or label position does not approve every variation. Photos should identify the inspected variant and include close views of any accepted or rejected deviation.

Treat Packaging as Part of Final QC

For a knock-down cat tree, final QC is incomplete until the packed set is reviewed. Confirm that the carton contains the correct boards, platforms, posts, covered parts, hardware pack, current manual and required labels. Check the packing order, internal protection, separation of surfaces and whether components can move in ways that may create contact or abrasion. Record carton condition, and verify carton dimensions or packed weight when the project requires those values.

A useful packed-unit check connects packing back to assembly: select a final packed set, verify its contents and assemble it using the included hardware, tool and instructions. This can identify revision mismatches or missing parts that an open-display sample would not reveal. The sampling plan and acceptance criteria remain project-specific.

Packaging checks should not be rewritten as guarantees of crush resistance, moisture protection, vibration performance or damage-free delivery unless the exact packaging configuration and test evidence support those statements. Packaging optimization may consider protection, carton dimensions, gross weight and handling constraints, but a methodology is not proof of a fixed shipping outcome.

Flat-pack cat tree packaging checked for components, hardware and assembly instructions
Open flat-pack cat tree packaging reviewed for components, hardware, protection and assembly instructions.

What QC Evidence Should Buyers Receive?

Inspection evidence should make the decision reviewable after the inspector leaves the site. Depending on the project, useful evidence may include measurement records, component and hardware photos, an assembly checklist, packed-unit photos, a nonconformity record and proof that an agreed correction was completed. Not every order requires the same document set; the buyer should define the required outputs in the QC plan.

QC areaWhat to checkUseful evidence
Reference controlApproved sample, specification and current revisionsReference list, dated approval and change record
Materials and componentsPart identity, specified dimensions, finish and interfacesInspection record, labeled photos and measurement record
Hardware and informationIdentity, count, labels, tool and manual matchHardware checklist and packing photos
AssemblyFit, alignment, sequence, connector engagement and missing partsAssembled-unit photos and completed checklist
StructureBase flatness, connections, platform support and documented wobble reviewNamed checkpoint record with close-view photos
AppearanceVisible surfaces, seams, edges, marks, color and exposed hardwareVariant-identified photos and defect record
PackagingComponents, protection, labels, manual, carton and required packed valuesPacked-unit photos, packing checklist and measurements when specified
DeviationsNonconformity, correction, recheck and approval ownerDeviation record and corrective evidence

A photo without a part code, measurement or inspection reference may be difficult to interpret later. Evidence should connect each finding to the named SKU, unit or sample, the document revision and the acceptance decision. If a deviation is accepted, record the scope of that approval so it does not silently become a new standard for unrelated products.

Buyer QC Checklist Before Shipment

Use this checklist as a starting point, then replace broad items with the critical dimensions, components and evidence requirements for the actual SKU or project.

  • The approved specification and drawings are current.
  • The approved sample or revision reference is identified.
  • Materials and components match approved definitions.
  • Critical project-specific dimensions are checked.
  • Hardware identity, count and tool are checked.
  • A representative production unit is assembled.
  • Connections, support and wobble checkpoints are reviewed.
  • Visible finish and appearance are reviewed after assembly.
  • The manual matches final parts and assembly sequence.
  • Packing, internal protection and labels are reviewed.
  • Deviations and corrective evidence are documented.
  • The responsible approval owner is confirmed.

A shipment decision should be based on the agreed acceptance plan and the recorded findings, not on unsupported claims about universal safety, stability or logistics performance. When a requirement is missing or contradictory, close the document gap before treating the unit as the production reference.
